Skip to content
New Gen A & B
Project Highlights
Phasing

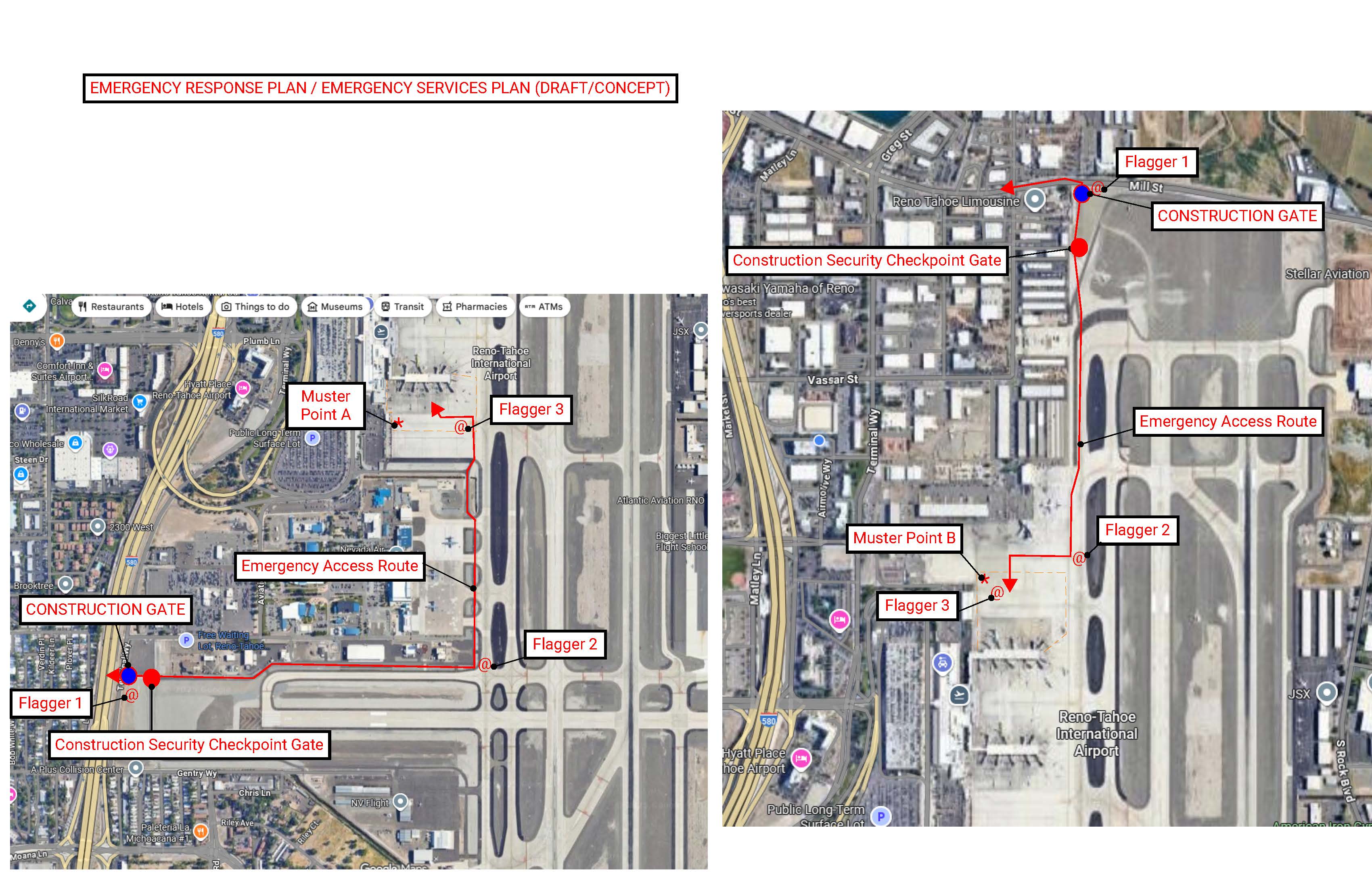

Emergency Evacuation Plan
Tenant Impacts
Passenger Assistance
Noisy Work Updates
Project Highlights
Phasing
Emergency Evacuation Plan
Tenant Impacts
Passenger Assistance
Noisy Work Updates

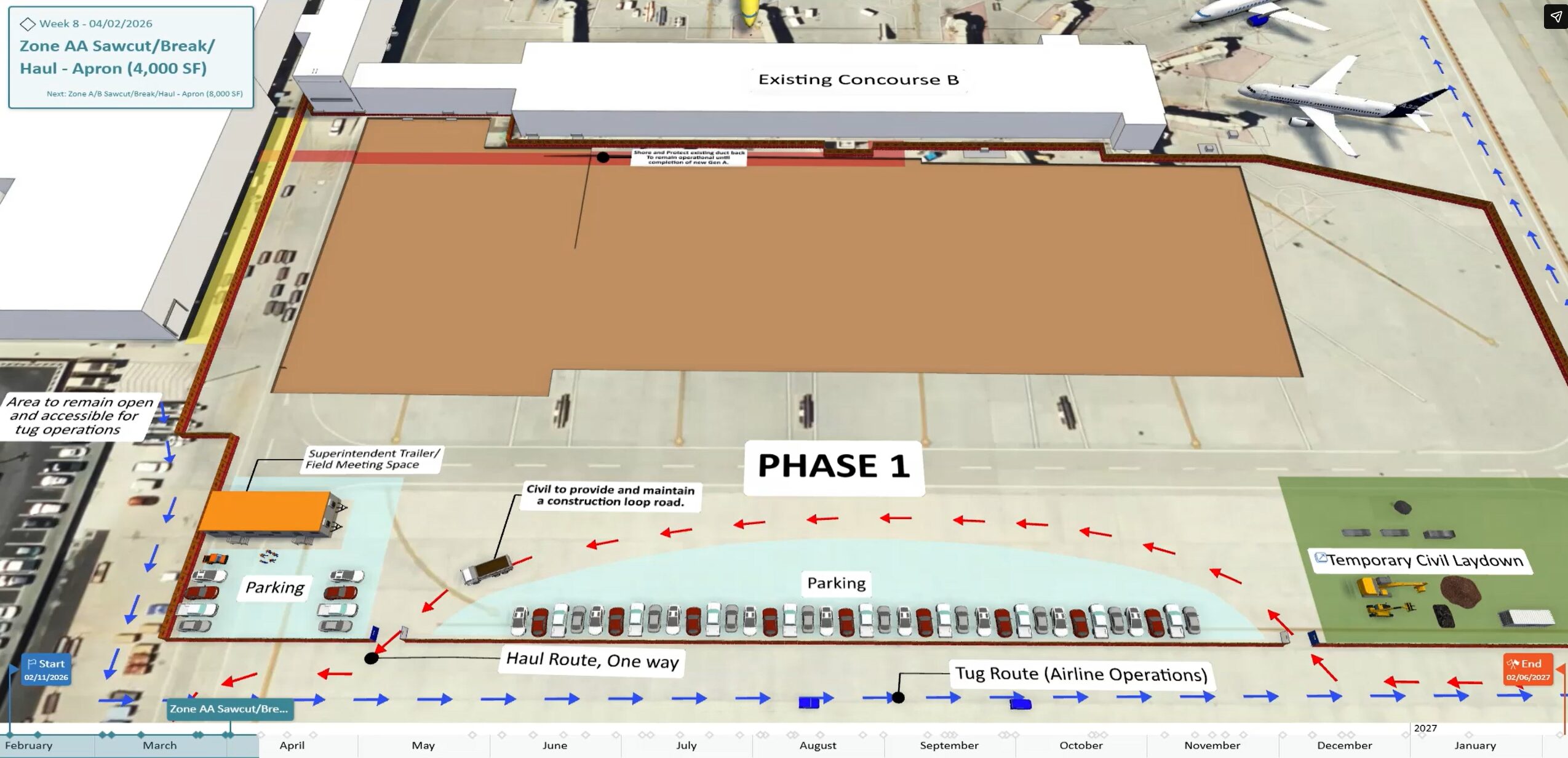

New GEN A&B

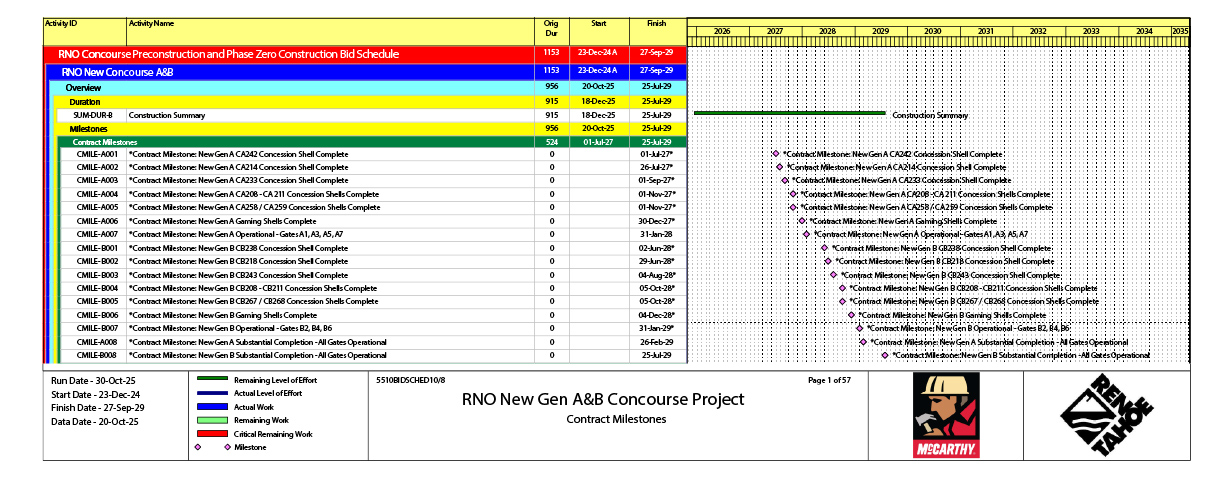

Milestones

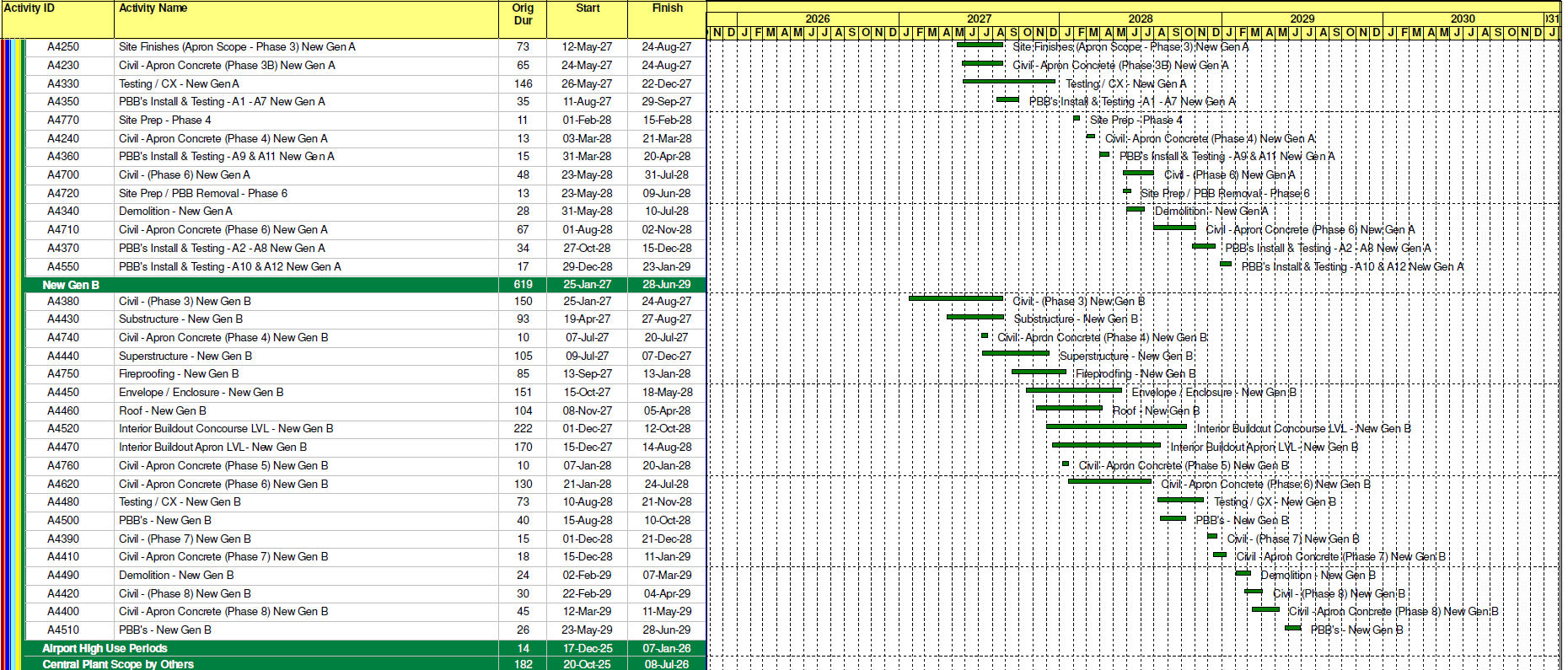

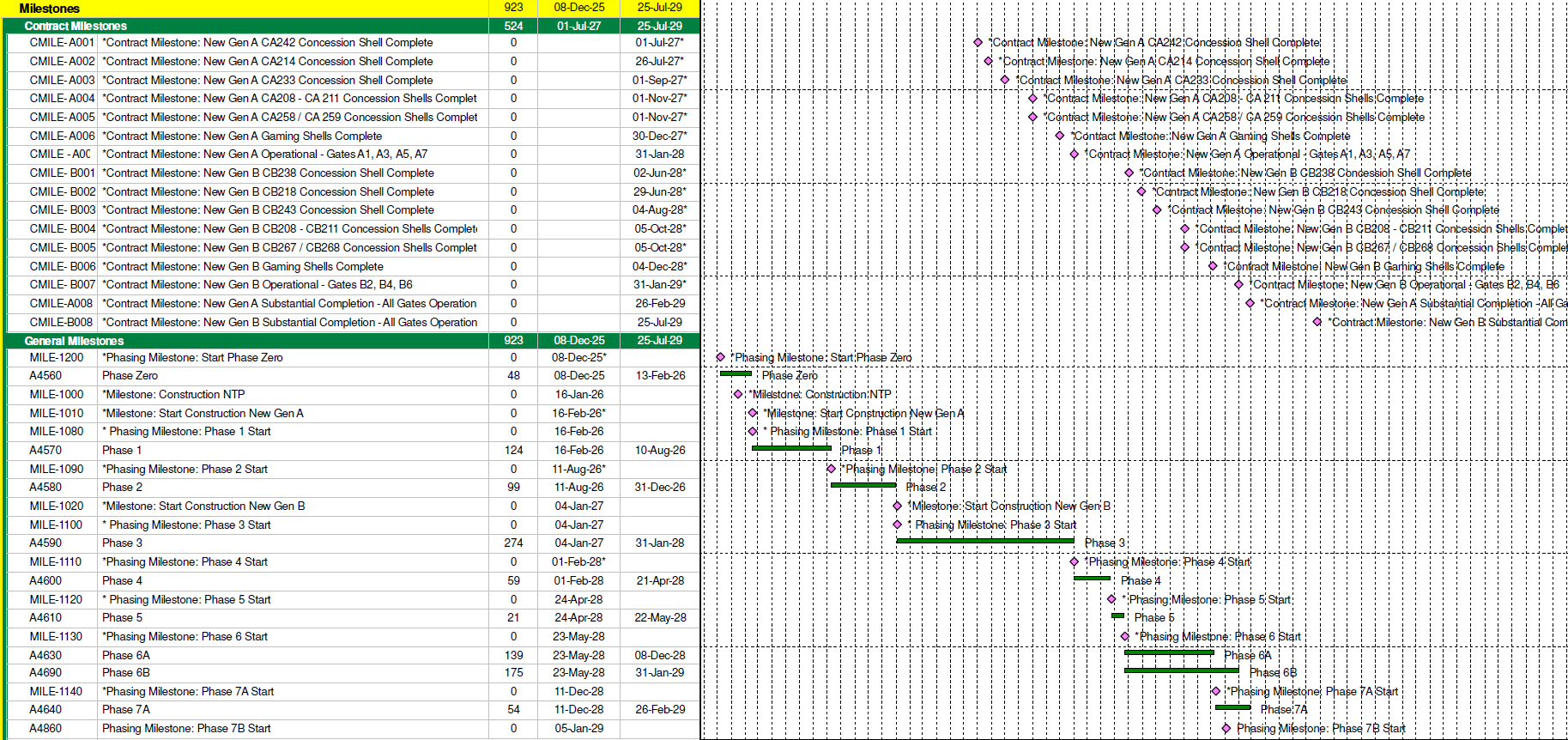

Schedule
Milestones Progress
Phase 2 - Complete 10/20/2026
2026 Phase 1
88.24%
Phase 3 - Start 10/22/2026
2026 Phase 1
0%

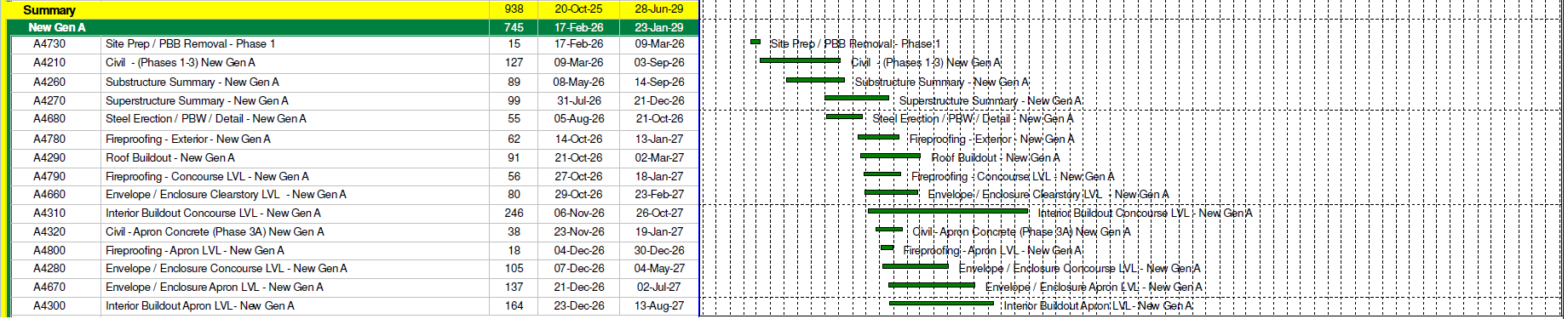

Schedule

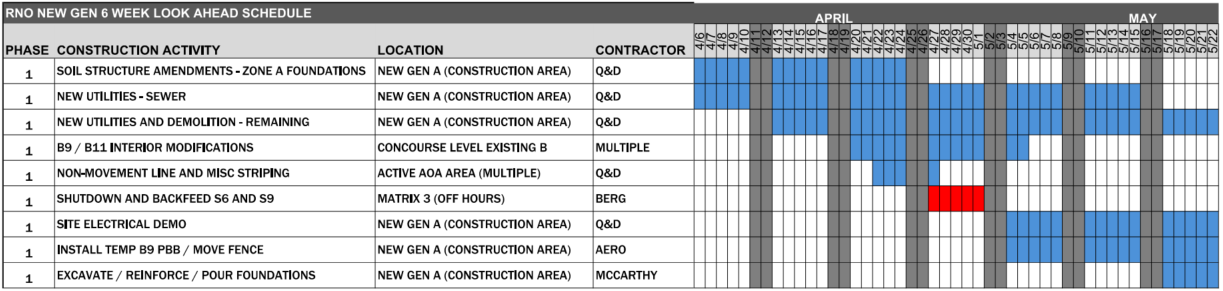

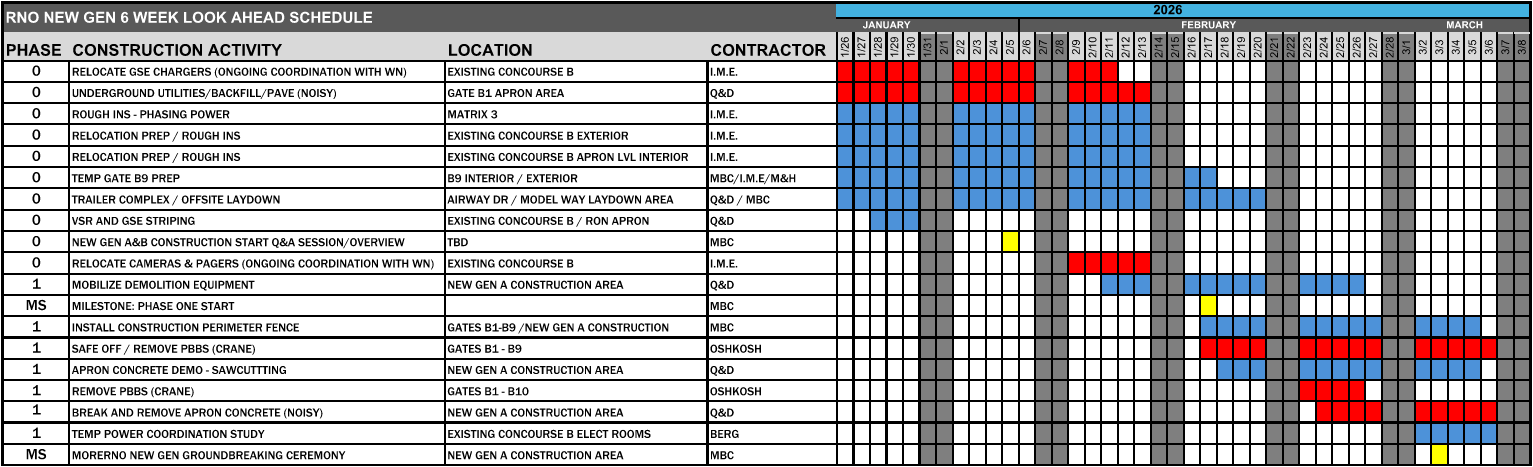

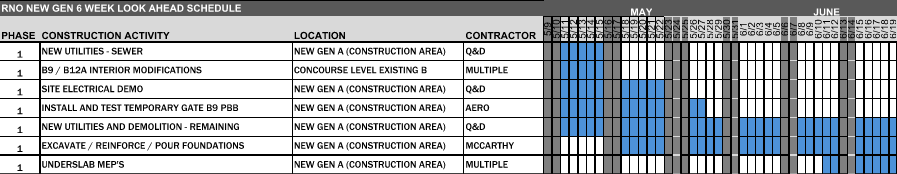

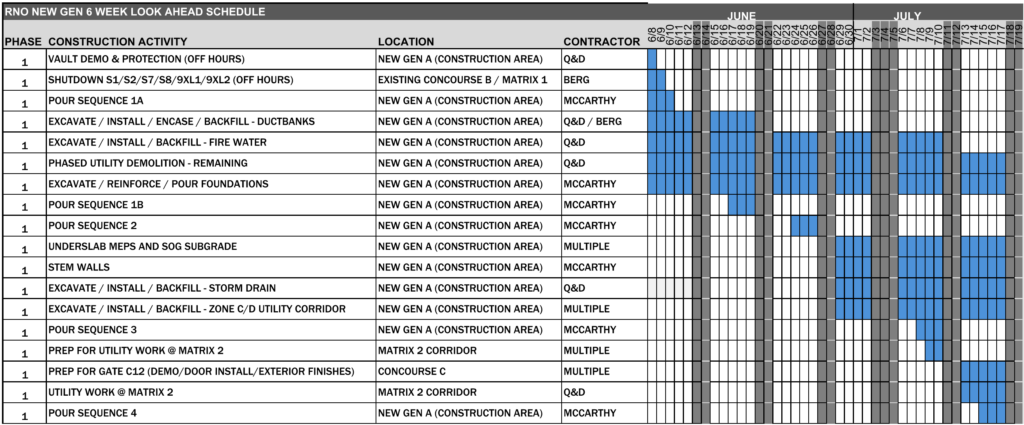

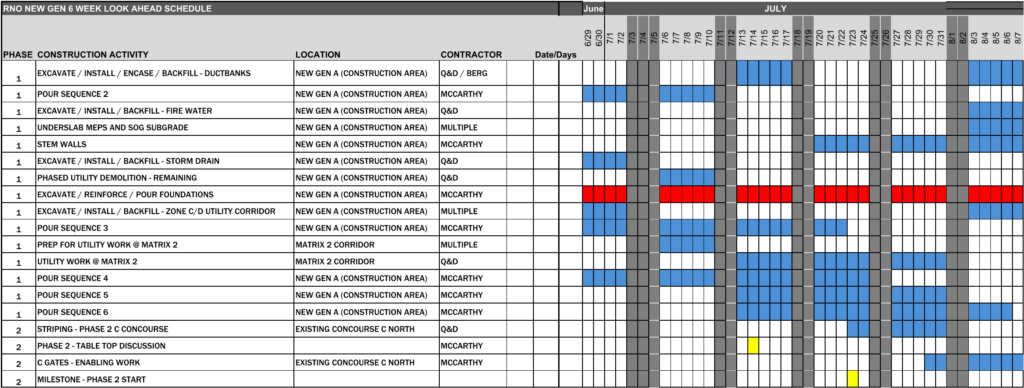

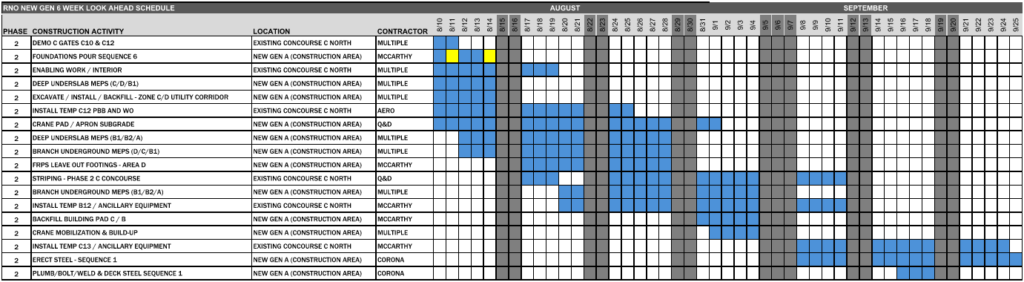

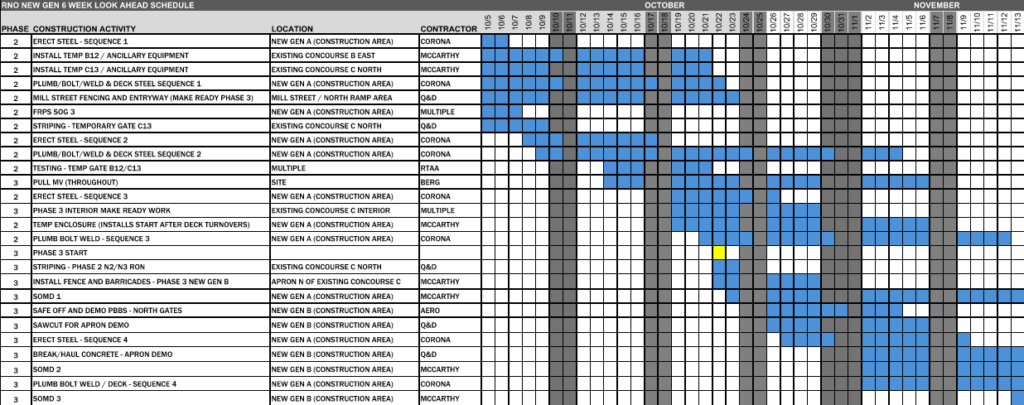

Look Ahead Schedule
Scroll to Top
